Building a reliable clean energy future

Reliable electricity is what keeps our homes, hospitals and businesses running every day. With EnergyConnect, we’re taking a big step towards securing that reliability, while opening the way for more renewable energy.

Construction and initial energisation is complete for EnergyConnect – Australia’s largest energy transmission project. Asset commissioning works are progressing ahead of inter-networking testing and integration into the National Electricity Market (NEM) by the end of 2026.

Stretching 900km across New South Wales, Victoria and South Australia, it has connected the three state grids for the very first time. That means:

  • Greater security of supply – keeping communities powered, even as energy demand changes.

  • Room for renewables – creating pathways for new wind, solar and other clean energy sources to plug into the grid as coal-fired plants close.

  • A stronger national network – enabling states to share energy when and where it’s needed most.

As a Critical State Significant Infrastructure (CSSI) project, EnergyConnect is central to the Australian Energy Market Operator’s plan for a more sustainable energy system.

Over the life of the project, Transgrid and our delivery partner have worked closely with communities, landholders and stakeholders to carefully plan and manage impacts to the surrounding areas. EnergyConnect isn't just new infrastructure, it’s a foundation for a cleaner, more reliable energy future.

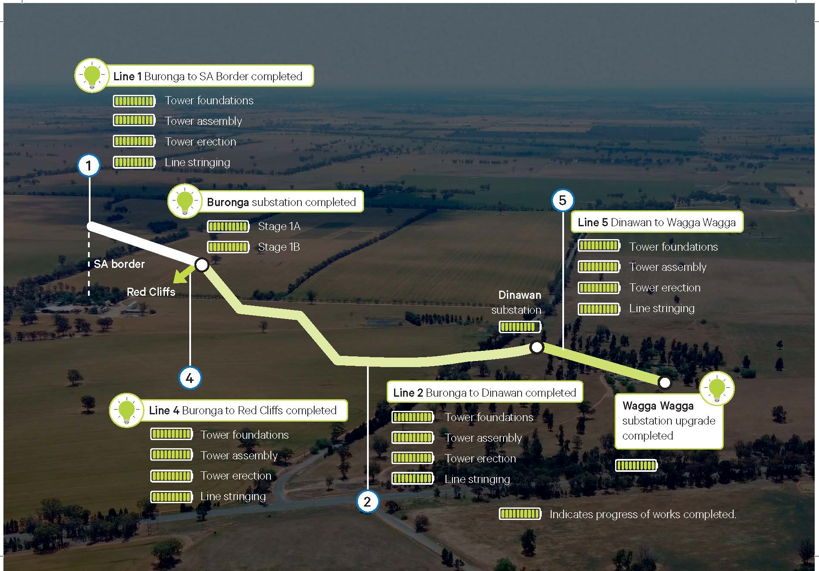

PEC benefit infographic

Project map

EnergyConnect Map new 230125

For a more detailed view of the EnergyConnect route, please visit our Interactive map.

Latest update

For more information about EnergyConnect post-construction activities, visit EnergyConnect - Elecnor (secureenergyjv.com.au). You can also reach the project team by calling 1800 49 06 66 or by email at pec.community@elecnor.es

Energy Connect milestones

  • ​Preliminary investigations and project scoping - Completed

    Regulatory approval received in July 2021

  • Community and landowner consultation - Completed

    From 2018

  • ​Project approvals - Completed

    Early 2020-mid 2022

  • Detailed design and site early works - Completed

    Early 2021 - mid 2022

  • Construction - Completed

    mid 2022-late 2024 (NSW Western Section) | mid 2023-early 2026 (NSW Eastern Section)

  • ​Project energisation - Completed

    late 2024 (NSW Western Section) | mid 2026 (NSW Eastern Section)

  • Rehabilitation of project corridor - In progress

    mid-late 2026

  • Project commissioning and inter-network testing - In progress

    mid-late 2026

  • Integration into National Electricity Market

    end of 2026
