Overview

HumeLink is a new 500kV transmission line which will connect Wagga Wagga, Bannaby and Maragle.

It is one of the state’s largest energy infrastructure projects, with about 365 km of new transmission lines, and new or upgraded infrastructure at four locations.

Why do we need HumeLink?

To meet our future energy demands, Australia needs to transition to a greater mix of low-emission renewable energy sources, such as wind and solar. HumeLink will deliver a more reliable and more sustainable grid by increasing the amount of renewable energy that can be delivered across the national electricity grid, helping to transition Australia to a low carbon future.

Project update

Main construction is in progress on HumeLink East and HumeLink West

The main construction works include construction of towers, building the new substations at Gugaa and Maragle, and upgrading existing substations at Bannaby and Wagga Wagga.

Transmission towers are being constructed in multiple stages, starting with excavation and foundation works, before progressing to tower erection and then stringing of the transmission lines.

Some enabling works – which started in early 2025 – will continue, including access point and access track establishment.

Accommodation facilities at Tarcutta and Kunama (HumeLink West), and Adjungbilly and Yass (HumeLink East) have been completed and have workers living on site.

Laydown facilities, which include equipment and materials storage, have been established at: Gugaa, Ellerslie, Maragle, Snubba Road and Batlow (HumeLink West), and Yass and Bannaby (HumeLink East).

Following consultation with community and stakeholders, additional laydown areas and concrete batching plant locations are being assessed at Lower Bago Road, Cullinga Park Lane, Honeysuckle Road and Gadara Road.

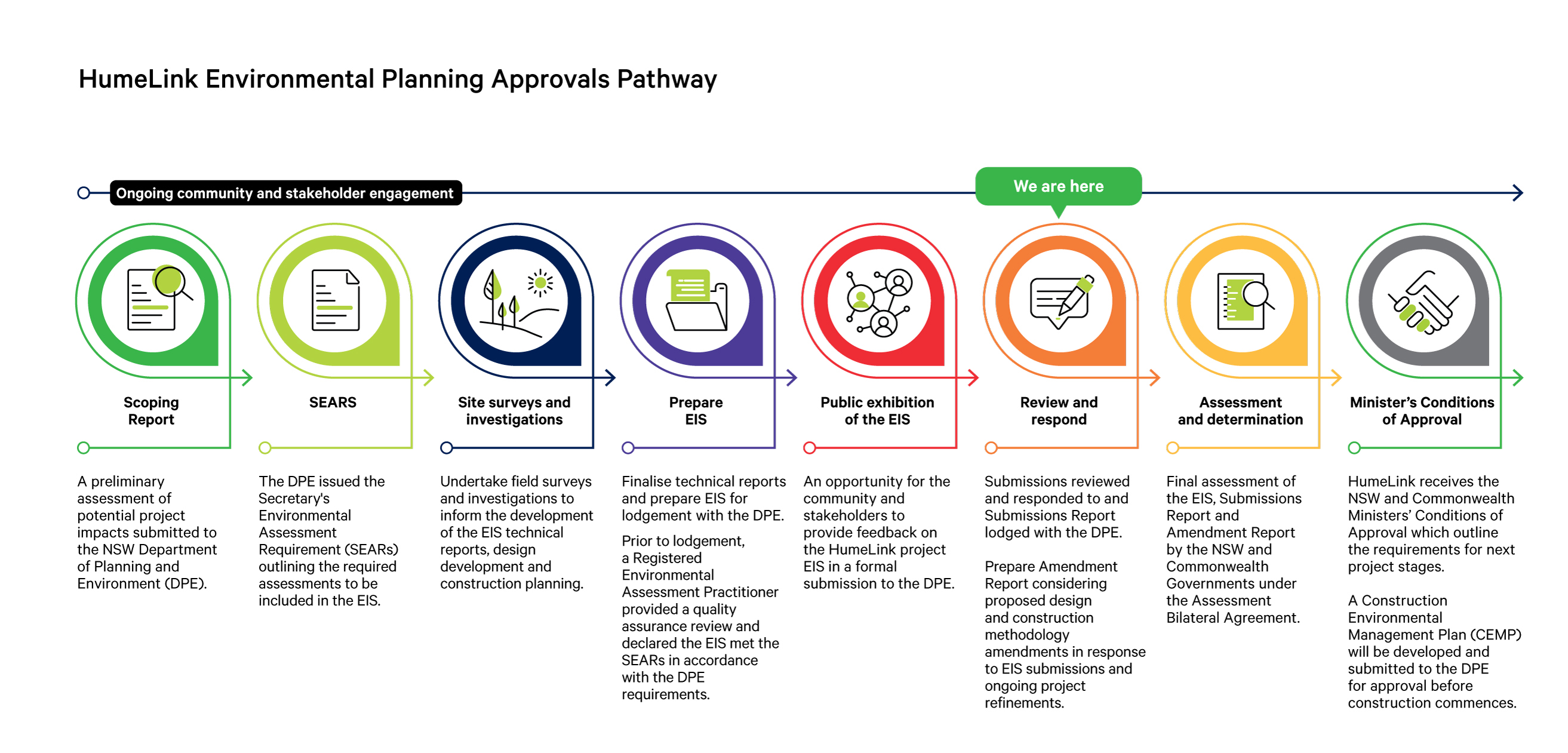

Timeline

  • Investigation of project options - Completed

    From 2019

  • Regulatory Investment Test (RIT-T) process - Completed

    From 2019, completed 2021

  • 1 km study corridor identified - Completed

    Early 2020

  • Community and landowner consultation - Completed

    Early 2020

    Community Consultative groups established late 2021

  • Environmental, field and technical studies - Completed

    From 2021 to 2023

  • Refined 200 m corridor announced - Completed

    Mid 2022

  • Secretary’s Environmental Assessment Requirements (SEARs) issued - Completed

    Mid 2022

  • Underground Feasibility Study - Completed

    Mid 2022

  • NSW Department of Planning and Environment’s public display of Environmental Impact Statement - Completed

    September - October 2023

  • Project Submissions Report and Amendment Report to NSW Department of Planning, Housing, and Infrastructure - Completed

    First half 2024

  • Planning approval obtained from State government - Completed

    November 2024

  • Planning approval obtained from Commonwealth government - Completed

    December 2024

  • Preparatory works, site establishment and early works - In progress

    Early 2025

  • Considered project status reached - Completed

    Mid 2025

    HumeLink is a Considered Project. To be classed as a Considered Project, the following conditions have to be met: necessary land and easements have to be acquired; all necessary planning and development approvals have to be obtained; the project has passed the Regulatory Investment Test for Transmission (RIT-T); and construction has either commenced or a firm date is set to commence.

  • Construction works starts on transmission lines and substations - In progress

    September 2025

  • Construction finishes - Proposed

    2027
